Skip to main content

Help center · Tutorial · 7 steps

Set up an industry-sponsored project: the template, milestones, obligations, files, and its NDA, IRB, and contract requirements

  • About 10 minutes
  • Free plan and up
  • Checked in the app on

Follow one industry-sponsored project from an empty form to a working record. By the end, the signed agreement is filed, the NDA, IRB approval, and contract are recorded with their expiry dates and signed copies, and the milestones are set with reminders. It starts from the Sponsored Research (Industry) template, which puts the milestones, obligations, and reporting cadence in place for you. Each step says exactly what to click and shows the screen you should see. Where a step differs on Pro, it says so. For an overview of everything a project workspace can do, rather than how to set one up, see the use case Manage an R&D collaboration project.

Before you start: you need an account and the signed agreement or its key dates, above all its start and end dates, because the template counts its dates from them. Your profile needs to be complete before you can create a project: your organization, your role, at least three expertise keywords, and a bio of at least 120 characters. The platform tells you what's missing. The sponsor's lead doesn't need an account yet. Inviting them is the next tutorial.

Step 1Create the project from the template

Open My Projects from the left sidebar and click New project. Fill in the form:

  • Title: what you'd want the sponsor to see, for example "Catalyst durability study, year one".
  • Description: at least 300 characters, covering the purpose, the research question, and a short summary of the scope and deliverables. The form counts the characters as you type. The title and description are what other members read first, and matching uses them to suggest collaborators.
  • Collaboration type: choose Sponsored Research (Industry) from the list. The list names specific agreement shapes, so pick the one that matches yours. Choosing it also chooses its template, below.
  • Visibility: on Free, projects are visible to Everyone. A signed-in member who isn't on the project sees the overview, the member list, and only the files you mark for anyone who can see the project. Milestones, discussion, and the activity log stay with members. On Pro, choose Private so only invited members can open it, or Organization to share it with members of the organizations you pick. If you belong to more than one organization, tick the ones that should see it.
  • Start from a template: Sponsored Research (Industry) is chosen for you, with its summary underneath. Click What this adds: 8 milestones, 5 obligations, monthly reporting to read the whole list before you create the project. Step 2 walks through it. Choose No template to start empty, or NDA-only scoping for a confidential first conversation before any agreement. There are 45 templates, one for each collaboration type plus NDA-only scoping, which is offered with every type. They work on every plan.
  • Paperwork this project needs: tick the NDA, IRB approval, or signed contract the agreement requires. The template ticks A signed contract (SRA, CRADA, or SOW) for you, and you can change it. A project with any of these ticked starts as a Draft, because it can't go active until each one is recorded (step 5). On Free the project stays visible to everyone even when it needs an NDA, and the form warns you, so keep confidential details out of the title and description.
  • Required expertise and Tags (both comma-separated), Start date and End date (changeable later). Use the agreement's own dates. The template counts most dates from the start, and dates the final report, the close-out, and the renewal decision from the end. Budget range is optional free text, such as " $150k to $200k over 18 months". The project's actual budget, with its lines and spending, goes on the Budget tab.

You can also invite members by email on this form. Leave it for now. Click Create project: with no paperwork ticked, the project is Active as soon as it's saved. With the template's contract box ticked, it starts as a Draft until you record the signed contract in step 5. If you'd rather finish setting it up first, click Save as draft instead: a draft stays out of Discover unless someone ticks the Draft filter. Either way, the project's Settings tab has a Status control that switches it between Draft and Active later.

The New project form filled in: the example title and a description of purpose, research question, and deliverables with its character count, Sponsored Research (Industry) as the collaboration type, Private selected for visibility, Start from a template set to Sponsored Research (Industry) with its summary, A signed contract (SRA, CRADA, or SOW) ticked under Paperwork this project needs with the note that the project starts as a draft, required expertise, tags, start and end dates, a budget range, and the Create project and Save as draft buttons.

Step 2Check what the template added

Creating the project from the template adds eight milestones with their checklists, five obligations, and a monthly reporting cadence. It also lists six suggested folders first on the Files tab. You can change or remove any of it afterward. The template is a starting point, not legal advice, and Helikon Labs isn't a law firm. The Activity tab records that the project was created from the Sponsored Research (Industry) template.

The template preview on the New project form, opened: the Sponsored Research (Industry) summary, What this adds with 8 milestones, 5 obligations, and monthly reporting, each milestone with when it falls and the size of its checklist, the five obligations with their kinds, the suggested folders, and the note on how dates are counted.

The milestones, in date order:

  • Sponsor payment, at the start, repeating every quarter. It's a payment milestone with no amount yet, so change it to the payment schedule in your agreement and set the amount.
  • Ready to start, a week in, with 8 checks, such as confirming that someone authorized on each side signed the agreement, an export-control screen, and a conflict-of-interest check.
  • Kickoff meeting, two weeks in, with 9 items, including the objectives, each side's lead, who decides what, and the escalation path.
  • Work plan agreed, about a month in, with 6 items, including the gate dates and the papers you expect, each listed as a publication review.
  • Quarterly management review, about three months in and repeating every quarter, with 6 items, including spending against the budget and a check for anything new that might be patentable.
  • Mid-project gate review, about six months in, with 9 items that lead to a Go, Conditional go, Hold, Recycle, or Kill decision.
  • Renew, redesign or exit decision, about two months before the end date, with 4 items.
  • Close-out, 30 days after the end date, with 8 items, including the final report's acceptance and lessons learned on both sides.

The obligations sit on the Overview tab, on the Obligations card:

  • Quarterly progress report to the sponsor, a sponsor report about three months in, repeating every quarter.
  • Final report, a deliverable due on the end date.
  • Sponsor review before publishing, a publication review.
  • Invention notice to the sponsor (through the technology transfer office), an invention disclosure.
  • Partner's license option window, listed as Other.

The last three show No due date yet. Add the date when one comes up, such as the day you send a manuscript for review. Each carries a note on the usual terms that tells you to check your agreement.

The project's Overview tab just after it was created: the Compliance card with Contract marked Required and a Mark signed button, and the Obligations card with Reporting: monthly, the quarterly progress report and the final report with their due dates, and three obligations with no due date yet.

Dates count from the project's start date, or from the day you created it if there's no start date. When the project has an end date, the template dates the end of the agreement from it. The final report is due on the end date. The close-out comes 30 days after it, and the renewal decision about two months before it. The quarterly reports and the sponsor payments stop about three months before the end, so the final report stands in for the last quarterly one. Without an end date, the final report falls about a year in. A repeating milestone or report adds its next occurrence when you finish the current one.

The reporting cadence shows on the Obligations card as Reporting: monthly, from the start date. On Pro, once the project is active, a draft status report opens at the end of each monthly period for the owner and admins to review.

The suggested folders are Contracts, Compliance, Technical, Reports & deliverables, IP / Prior art, and Risk management. They're listed first when you upload a file (step 4), and every other folder is still there.

Step 3Flag the paperwork the project needs

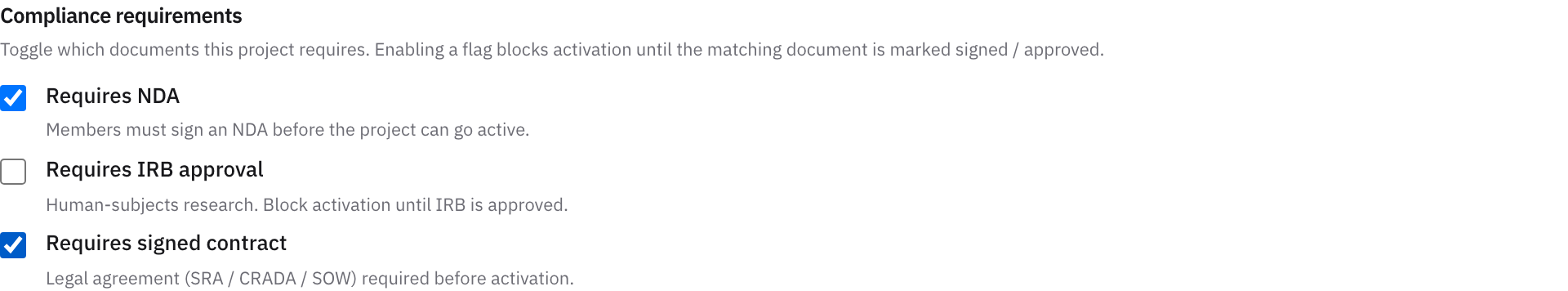

If you ticked the paperwork on the form, or kept the template's contract box, it's already set, so skip to step 4. To change it later, open the project and go to its Settings tab. Under Compliance requirements, tick each one the agreement requires: Requires NDA, Requires IRB approval, Requires signed contract.

A requirement that's ticked blocks the project from moving to Active until the matching record is marked signed or approved. Ticking one on a project that's already active doesn't pause it. It stays Active, and the requirement shows as Required on the overview until you record it in step 5.

The Compliance requirements panel with Requires NDA and Requires signed contract ticked and Requires IRB approval unticked.

Step 4File the agreement

Do this before recording the dates, so the record in step 5 can point at the signed document.

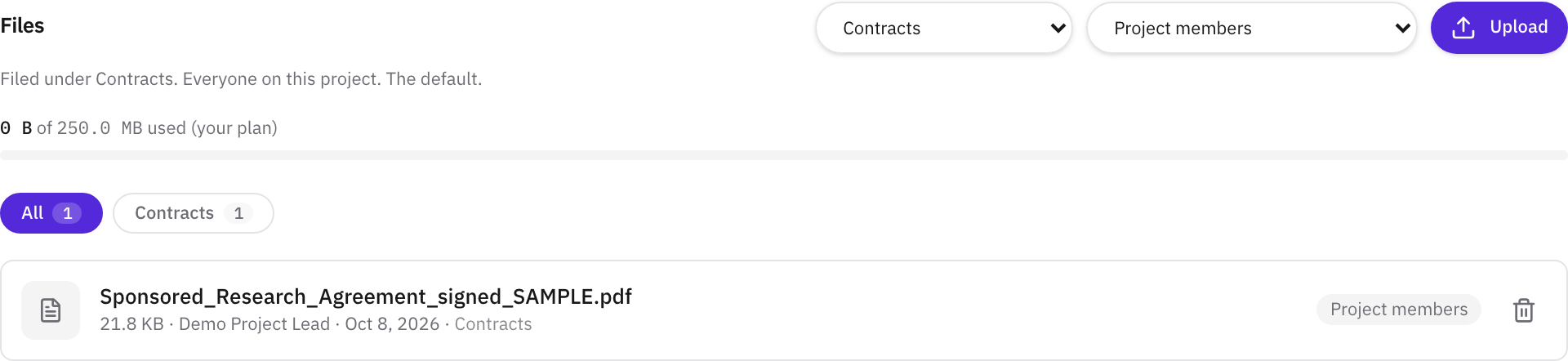

Open the Files tab. Pick the folder first, from the dropdown beside Upload: Contracts for the signed agreement, Technical for data and protocols, Reports & deliverables for the sponsor reports. On a project created from a template, the dropdown lists the template's folders first, under Suggested for this project. Choose the folder before you pick the file. You can move a file later with the pencil button on its row, Audience and folder, which also changes who can open it. To file a newer copy of the same document, use Upload a new version on its row, and the earlier versions stay in its history. Then set who can open the file: Project members (the default) for the agreement, Only me for a draft that isn't ready. The other two options are My organization and Anyone who can see the project. A file can never be more visible than the project it sits in.

Storage counts against the project owner's plan. Each plan's allowance is on the pricing page.

The Files tab with Contracts and Project members chosen beside the Upload button, and the signed agreement listed under Contracts with its audience shown as Project members.

Step 5Record the signed NDA, IRB approval, and contract

Back on the project's Overview tab, the Compliance card lists each requirement as Required. Only the project owner sees its buttons. Click Mark signed (or Mark approved for the IRB) and enter:

  • Signed on (or Approved on for the IRB), which defaults to today
  • Expires on, optional: left blank, it defaults to two years after signing for an NDA and one year for an IRB approval or a contract
  • Linked document, optional: the signed file from step 4. The list shows files in the Compliance folder by default. If you filed the agreement under Contracts, click Show any folder and choose it.

Click Mark signed. The card shows the requirement as Signed with its expiry date, and an audit entry is logged. From then on, the project owner gets an email 14, 7, and 3 days before it expires. This works on every plan.

For the IRB, Mark approved first asks for the IRB's Decision: Approved, with an expiry date, Approved, no continuing review, Exempt, or Not human subjects research. Only the first takes an expiry date, because the other three don't expire.

When everything the project needs is recorded, open Settings and click Active under Status.

The Mark contract signed dialog with Signed on and Expires on filled in, Show any folder selected, and the signed agreement from the Contracts folder chosen as the linked document.

Step 6Assign and adjust the milestones

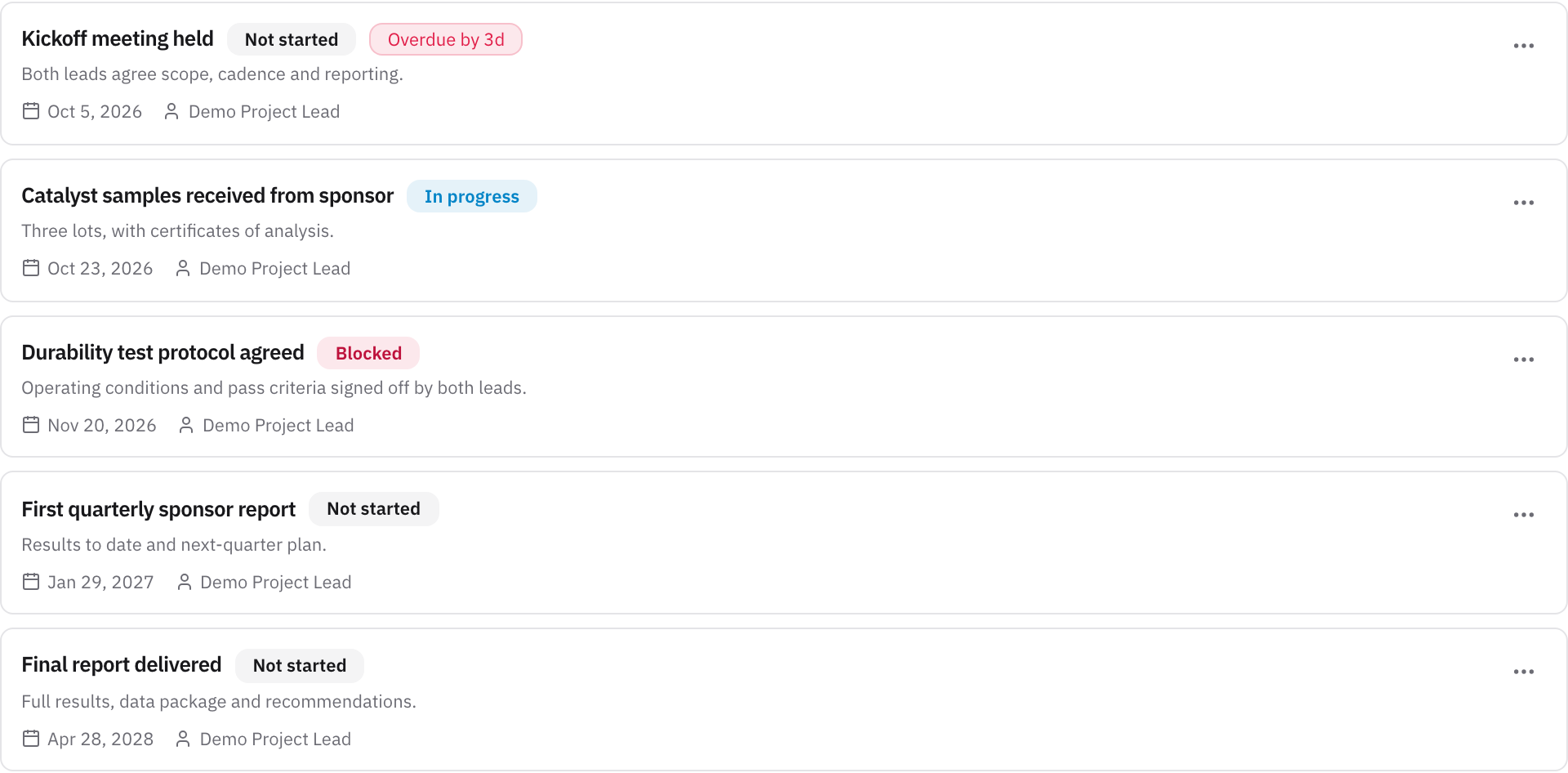

Open the Milestones tab. The timeline at the top draws each milestone at its due date. Below it, the form takes a Title, a Description (useful for acceptance criteria), a Due date, and an Accountable person from the project's members. Click Add milestone for each one you need beyond the template's eight. More options makes a milestone repeat or marks it as a payment.

The template's milestones start with nobody accountable, so give each one a person with Edit details. Add any milestone your own agreement calls for, such as "Samples received from sponsor". Checklist on each milestone opens its items: tick them as they're done, or add your own with a due date and a person. There's no limit on how many milestones a project can hold, on any plan.

Each milestone has a status, set from its ⋯ menu: Not started, In progress, At risk, Delayed, Blocked, On hold, Completed, or Canceled. A milestone past its due date shows an Overdue flag unless it's completed or canceled. Edit details in the same menu changes the title, description, due date, and accountable person, and how it repeats or pays. Until the sponsor's lead has joined, assign their milestones to yourself and reassign them after the invitation (next tutorial).

Reminders need no setup. The accountable person, anyone watching the milestone, and the project owner each get an email three days before a milestone is due, another the day before, and one the day after it becomes overdue. A checklist item with a due date reminds its person the same way. Completed and canceled milestones stop sending reminders. Anyone can turn these emails off with Project deadline reminders in Settings, under Notifications. For repeats, watchers, baselines, and the timeline, see How to plan a research project schedule.

 The Milestones tab of a project just created from the template: the first milestones in date order, Sponsor payment with its Payment badge and its quarterly repeat, and Ready to start with its eight-item checklist open.

Step 7Check the dashboard and request the kickoff meeting

Open your Dashboard. The Milestones due panel lists the project's upcoming and overdue milestones, and it appears on the dashboard of everyone on the project, not only the accountable person.

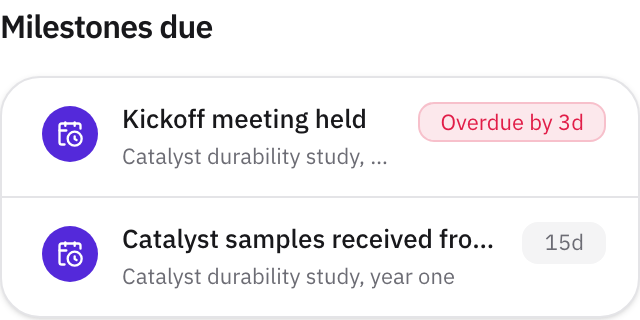

The Milestones due panel on the dashboard: the kickoff milestone flagged Overdue by 3 days and the samples milestone due in 15 days.

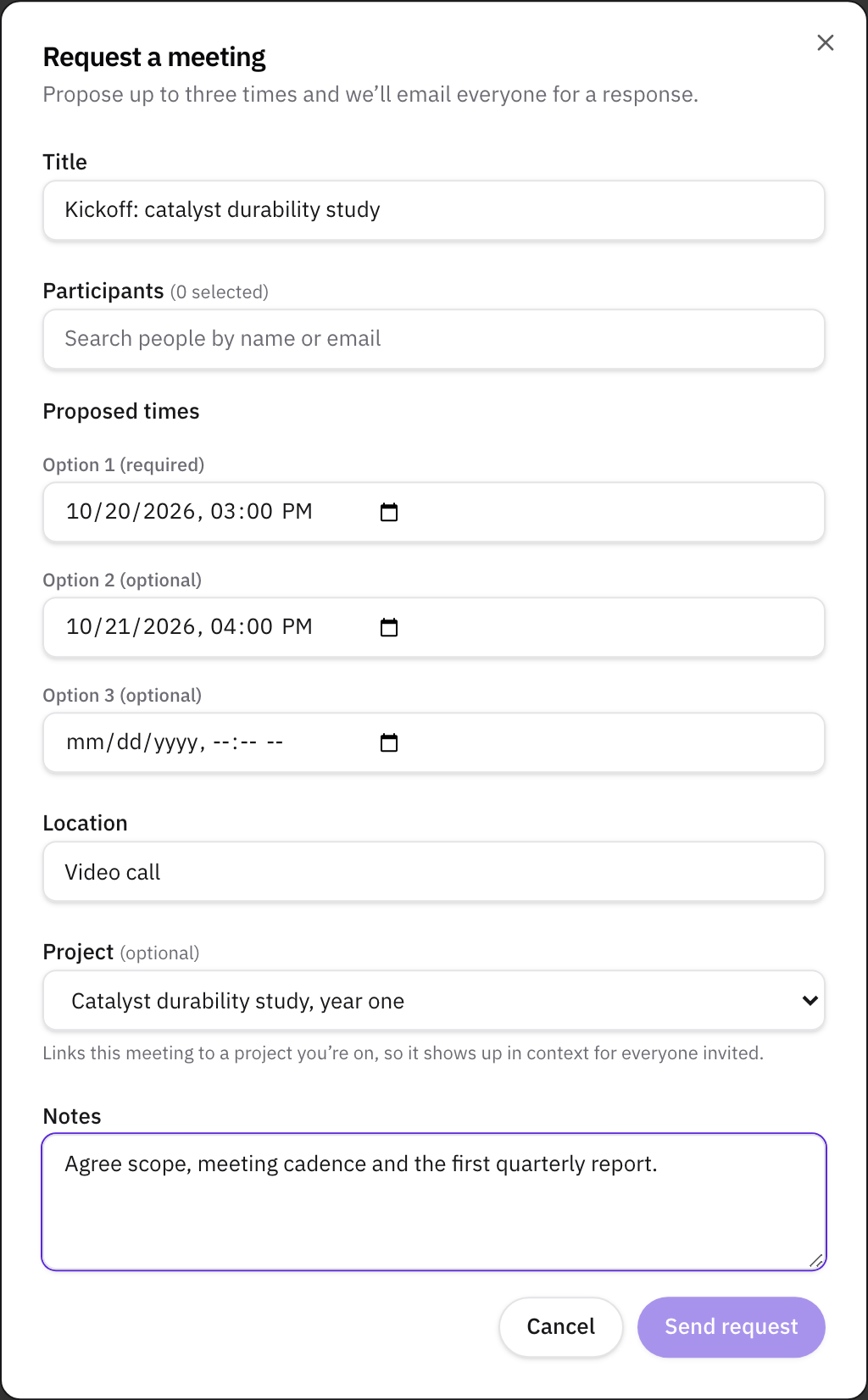

Then request the kickoff meeting. Open Connect from the sidebar, go to Meetings and click New request. Give it a title, add the participants, propose up to three times, add a location and notes, and choose the project under Project so the meeting shows up in context for everyone invited. Click Send request. Each participant is emailed to accept a time or suggest another. Once a time is confirmed, everyone gets a calendar invite by email that adds to Google, Outlook, or Apple Calendar. A change made in a calendar app doesn't flow back to the platform, so if the time moves, change it on the meeting.

The Request a meeting dialog with a title, two proposed times, Video call as the location, the project chosen under Project, and notes.

What to do next

Related
